Plastic Injection Molding Offshore
The $60,000 Mold That Cost $300,000 (And How to Offshore Right)
I’d been brought on as their in-house project engineer specifically to manage launches like this one.

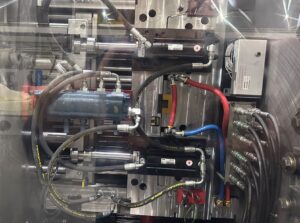

My new employer had just taken delivery of their Dock Mate decking tooling – 3 molds with 24 interchangeable insertsdesigned to run across all three tools. Dense rib structure, nice part design. They’d gone offshore and paid $60,000 fortooling that would have cost $120,000 domestically.
It was an understandable decision. The business case looked solid. Cut tooling costs in half, maintain quality, get to marketfaster. On paper, it made perfect sense.
Then we tried to run production sampling.
Parts were stuck in the mold. Not a little resistance. Not “we need to adjust the ejection timing.” These parts were
locked
into the tooling.
Here’s what made it puzzling:
The offshore supplier had sent trial samples. Two parts. They looked good – clean surfaces,nice details, no visible defects. The supplier had run trials at their facility with no ejection issues reported.
Two parts out of 24 inserts across 3 molds. Two parts that happened to tell us everything was fine.
They weren’t lying to us. They just didn’t know yet what their worn tooling had done to the other 22 inserts.
What Ejection Problems Actually Mean
Let me explain what ejection problems actually mean – because this isn’t just an inconvenience, it’s a production killer.
When a part won’t eject cleanly from a mold, you can’t run production. Every cycle, an operator has to manually pry the partout or wait for it to cool further (killing cycle time). If you force ejection, you risk:
Broken ejector pins (downtime for repair)
Deformed parts (100% scrap)
Damaged mold surfaces (expensive repairs)
Operator injury (prying hot plastic out of steel tooling)
You’re not making parts. You’re not making money. You’re burning cash on every cycle while your customer waits for theirproduct and your press sits there running but not producing.
We had three molds that couldn’t run. The clock was ticking. And I needed to figure out why.
The Investigation
I started where you always start with ejection problems – examining the parts and the tooling.
The parts showed drag marks along the ribs. Consistent pattern. Not random damage from forced ejection – this washappening
during
ejection. Something was physically holding the parts in the mold.
I pulled the inserts and inspected them closely. That’s when I saw it.
The ribs on the mold weren’t clean vertical walls. They had a slight undercut – the steel actually hooked back under itself atthe base of each rib. Not much. Maybe a few thousandths of an inch. But enough that the plastic was locking behind that
hook during ejection.
This wasn’t a design problem.
The part design was fine. The ejection system was properly designed. This was amanufacturing defect in the tooling itself.
Time for the 5 Whys.
Why won’t the parts eject?
Because there’s an undercut on the rib geometry in the mold.
Why is there an undercut?
Because the steel was cut at the wrong angle during machining.
Why was it cut at the wrong angle?
Because the cutting tool deflected under pressure during the machining operation.
Why did the cutting tool deflect?
Because the tool bit was dull and couldn’t handle the feed rate pressure.
Why was the tool bit dull?
Because they didn’t change it. They forgot to sharpen the saw.
There it was.
Not a sophisticated design failure. Not a complex engineering miscalculation. A worn-out milling bit that bent underpressure and cut the wrong profile into 22 out of 24 inserts.
The two sample parts that looked good? Those came from the inserts machined before the bit dulled. Early in the run, whenthe tooling was still sharp. By the time they finished the rest of the inserts, the bit had worn down enough to deflect andcreate that tiny undercut on every rib.
They’d sent us the good ones. Not intentionally misleading us – they just hadn’t caught it yet.
The Emotional Roller Coaster
Acknowledgment:
We had a problem. A real one. Three molds, 22 defective inserts, production stopped, customer waiting.
Cost implications:
My boss was freaking out. Understandably. We hadn’t shipped product on schedule. Every day of delaywas costing us money and credibility. The customer was calling. “How much is this going to cost to fix? Do we need newmolds? How long?”
Nobody wanted to hear “I don’t know yet.”
But I couldn’t give answers I didn’t have. What I
could
do was gather information and find the people who could solve this.
The Real Heroes
Let me tell you about the operator.
These are large parts – 4 feet square, 30 pounds each. The system was designed for gravity-assist ejection. When everythingworks right, the part ejects, falls into a chute, and feeds down to the operator. Clean. Safe. Efficient.
When parts stick, that whole system fails.
The chute has to be removed. The press is open. And now you’ve got an operator standing in front of an open press, reachingin with tools, trying to extract a 30-pound part that’s locked into hot steel tooling.
Every. Single. Cycle.
This wasn’t just inconvenient. This was dangerous. He was going to the point of danger to keep production moving while wefigured out the problem. Prying, levering, working angles to release parts without damaging them or the mold or himself.
I can’t say enough about what that operator went through.
But here’s what mattered: he was
invested
. He wasn’t just complaining about the problem. He was providing information.”This rib sticks worse than that one.” “These two inserts run clean.” “When I hit it here, it releases, but when I hit it there, itdeforms.”
Diagnostic data from someone living with the problem. That information was gold.
The Collective Solution
I brought the setup guy into the conversation. He’d been doing the tool changes, swapping inserts, trying differentconfigurations to find the good ones. He confirmed what the operator was seeing and what I was finding in my inspection:two inserts were fine, the rest were trouble.
Then I called our local toolmaker.
This relationship had been groomed over time.
We’d built this connection through fair dealing, clear communication,mutual respect. He understood our shop’s requirements, and therefore our customer’s requirements. He knew his owncapabilities. He knew we were good for payment and wouldn’t jerk him around.
When relationships are built properly –
before
the crisis – you don’t have to convince people to help you. They’re alreadyinvested.
I explained what the operator was experiencing. I showed him the setup guy’s notes. I walked him through my inspectionfindings – the undercut, the deflection pattern, the root cause analysis.
He looked at the inserts and said:
“I can fix this.”
Not “maybe.” Not “we’ll need to send them out.” Not “this is going to take weeks.”
“I can fix this.”
That response was built over time.
He knew what he was saying yes to. He knew we needed it done right, done fast, anddone within reason. And he knew we’d treat him fairly when it came time to settle up.
The Solution
Individual re-machining of each defective insert. Fresh, sharp cutter with the proper draft angle built into the bit. Clean upthe deflection undercut, restore the correct geometry.
The cost? $10,000. Inconsequential compared to the alternative, but also remarkably low for the expertise and turnaroundwe needed.
The timeline? Three days to get us back up and running with one good set of inserts. Production resumed. The operatorcould step back from that open press. The parts fell into the chute like they were designed to do.
The remaining inserts were completed over the next three weeks as we sampled and refined.
My job was to translate this solution back up the chain. I walked into my boss’s office with a plan, a timeline, and a costestimate that was shockingly reasonable compared to the nightmare scenarios we’d been imagining.
The calming effect was immediate. Not because the problem was gone, but because we had a path forward. We hadresources. We had people working together toward a solution.
This is what grooming resources looks like.
The operator who knows his machine and risks his safety to keep thingsmoving. The setup guy who tracks patterns and knows which inserts run clean. The local toolmaker who’s been there before,knows we’re fair dealers, and can say “I can fix this” with confidence.
You don’t build these relationships during the crisis. You build them beforehand, so when the crisis comes, you know who tocall and they know you’re worth helping.
The Real Cost of “Savings”
Let’s do the math on that $60,000 “bargain.”
Offshore tooling cost:
$60,000
Domestic tooling would have been:
$120,000
Apparent savings:
$60,000
Actual costs:
Engineering time (investigation, root cause analysis, coordination)
Design recovery time
Local toolmaker intervention: $10,000
Lost time to market
Trial press time (sampling, failed cycles, operator overtime)
Scrap parts during troubleshooting
Operator risk and inefficiency (manual extraction vs. gravity feed)
Conservative total: $300,000
We didn’t save $60,000. We spent an extra $180,000.
And that doesn’t account for the stress, the safety risk to our operator, the damaged relationship with our customer waitingfor delayed product, or the opportunity cost of having our best people firefighting instead of working on the next launch.
How to Offshore Right
I’m not telling you to never use offshore tooling. Cost matters. Global supply chains are real. Sometimes offshore is the rightcall.
But here’s what that $60,000 tool deserved: $2,000 of someone’s time to properly vet the supplier.
Be intimate with your supplier.
Not just the sales team. Not just the project manager. Get on the floor with the toolmakersdoing the actual work. Talk to them. Understand their process. Ask questions like:
“Show me your tool maintenance protocols. When do you change bits?”
“Walk me through your quality checks during machining.”
“What’s your sampling process? How many cavities do you sample before shipping?”
“Who inspects the work and what are they looking for?”
If a tool is worth $60,000, it’s worth you understanding who’s making it and how they work.
If you can’t be there yourself
– and often you can’t –
find someone with your vested interest at hand.
A third-partyinspector. A trusted agent in-country. Someone who can be your eyes and ears on that shop floor.
In the design review stage
, assess supplier capability as rigorously as you assess the part design itself. This is where front-loading prevents expensive failures. Ask:
Does this supplier have experience with this type of geometry?
What’s their track record with similar complexity?
Do they have the right equipment and maintenance protocols?
Can they sample all cavities, not just a representative few?
Build your local resources before you need them.
We had a local toolmaker on speed dial because we’d invested in thatrelationship long before this crisis. Fair dealing. Clear communication. Mutual respect. When we called, he knew we wereworth helping.
That relationship saved us. Not just money – time, credibility, and an operator’s safety.
The Vertical Launch Method in Action
This is what proper design stage work looks like:
Supplier vetting as part of design review
– not just part design, but maker capability
Stakeholder engagement
– operator, setup guy, toolmaker all contributing expertise
Root cause analysis
– 5 Whys to find the real problem, not just symptoms
Resource grooming
– relationships built before the crisis so solutions come fast
Clear communication
– translating technical problems into actionable plans for leadership
We never have time or money to do it right, but we always find time and money to fix bad tooling.
The question is: would you rather spend that time and money on the front end, or the back end?
Front-loading the design stage – taking twice as long as you think you need, doing thorough supplier assessment, engagingall stakeholders, building resource relationships – that’s not extra cost. That’s insurance.
This project taught us that lesson at $180,000 over budget.
How much is your next lesson going to cost?
If This Sounds Familiar
If you’re reading this and thinking “we’ve been there” or “we’re there right now,” you’re not alone. Most manufacturers havea version of this story. The offshore tool that looked great on paper. The crisis that followed. The expensive scramble to fixit.
The difference is whether you learn from it or repeat it.
At Launchpad Project Management, I help companies front-load their design processes so launches work from day oneinstead of months of firefighting. Supplier vetting. Stakeholder engagement. Resource development. The unglamorous workthat prevents expensive disasters.
Because I’ve lived through these disasters. I’ve been the engineer standing in front of an open press with a stuck part. I’vebeen the one calming down leadership while coordinating a solution. I’ve been the one who built the relationships that savedthe project.
That experience is available to you.
If you’re facing a product launch, a new supplier relationship, or a tooling decision that keeps you up at night – let’s talk.Before it becomes a $300,000 lesson.
Categories: Injection
